Deck Footing Options in Ontario: Sonotubes vs Helical Piles (Pros & Cons)

Footings are where decks become "real construction." In Ontario, freeze-thaw and soil conditions mean your support system matters more than the surface boards. A beautiful composite deck on underbuilt footings will heave, crack, and pull away from the house within a few winters.

This guide breaks down the two most common footing types used in Kitchener-Waterloo-Cambridge (KWC): sonotube concrete footings and helical piles.

Why Footings Matter More in Ontario

Ontario's climate puts unique stress on deck foundations. The ground in KWC freezes and thaws dozens of times per winter, and that cycle pushes shallow footings upward — a process called frost heave that can shift a deck several inches in a single season.

Three factors make this region especially demanding:

If footings are too shallow, too narrow, or poorly drained, the deck will move. The fix is almost always more expensive than doing it right the first time. For more detail on depth requirements, see the frost depth guide.

Sonotube Concrete Footings

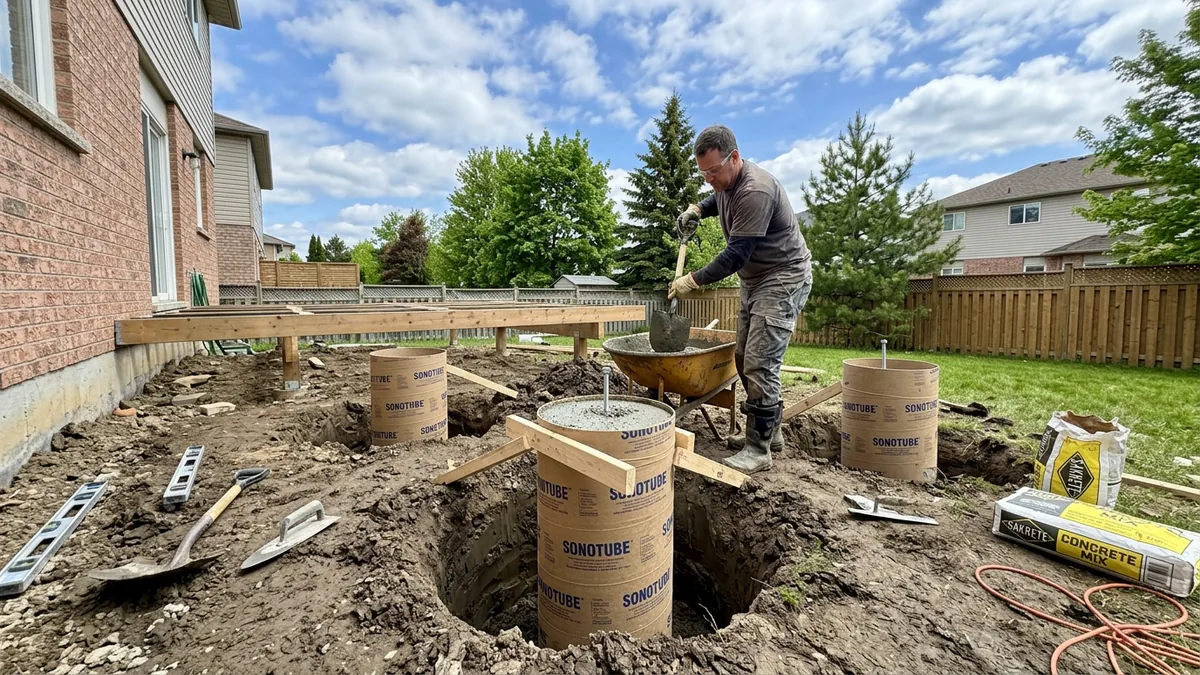

Sonotubes are waxed cardboard cylinders used as forms for poured concrete. They have been the standard deck foundation method in Ontario for decades.

Installation Process

1. Mark and dig: Holes are dug to a minimum of 48 inches, plus a few extra inches for a gravel pad. In KWC clay, this often means a 54-60 inch total dig.

2. Set the form: A 10" or 12" diameter sonotube is placed in the hole on a compacted gravel base and levelled.

3. Add rebar: Two or three pieces of 15M rebar are tied together and placed inside the tube, extending from the gravel base to near the top.

4. Pour concrete: Ready-mix concrete fills the tube, is rodded to remove air pockets, and finished flush. A post bracket is set into the wet concrete.

5. Cure: In warm weather, footings can typically be loaded after 3-7 days. Below 10C, curing slows significantly and may need frost blankets.

6. Inspection: Most KWC municipalities require a footing inspection before framing begins. The inspector checks depth, diameter, rebar, and bracket placement.

Pros and Cons

Strengths: Proven and well-understood by inspectors, high load capacity (a 12" tube can carry well over 5,000 lbs), no specialized equipment needed, and lower per-footing cost on easy-access sites.

Limitations: Excavation is difficult in tight backyards or sloped lots. Concrete should not be poured below -10C. Each 48" hole produces a pile of spoil that needs hauling. Curing time and inspection scheduling add days to the project.

Helical Piles

Helical piles (sometimes called screw piles) are steel shafts with helical plates. A hydraulic drive head on a compact excavator rotates them into the ground like a giant screw.

Installation Process

1. Machine setup: A compact excavator with a hydraulic torque head fits through a 36-inch gate opening, making backyard access easier than a full excavation crew.

2. Drive the pile: The operator rotates the pile into the ground. A single pile takes 5-15 minutes depending on soil.

3. Torque monitoring: The machine monitors torque throughout. When the target torque is reached past frost depth, installation is complete.

4. Cap and bracket: A steel bracket is welded or bolted to the top, trimmed to the correct height.

5. Engineering certificate: Most installers provide a torque log and engineering certification documenting depth, torque, and calculated load capacity for each pile.

Pros and Cons

Strengths: A typical deck (6-8 piles) installs in half a day. Works in frozen ground, so late fall and winter builds are feasible. Minimal site disruption — no spoil, no concrete truck. Framing can start the same day.

Limitations: Higher per-unit cost, especially on small projects. Requires a certified installer. Rocky ground can force pile relocation. Less familiar to some inspectors, though KWC acceptance has grown significantly.

Side-by-Side Comparison

| Factor | Sonotube | Helical Pile |

|---|---|---|

| Cost per footing (KWC) | $150 - $250 | $200 - $400 |

| Install time per footing | 1-2 hours + curing | 5-15 minutes |

| Time before framing | 3-7 days (curing) | Same day |

| Season flexibility | Spring through early fall | Year-round |

| Min. temperature | Above -10C | No practical limit |

| Site access needed | Excavator or hand dig | Compact machine (36" wide) |

| Spoil / cleanup | Significant | Minimal |

| Clay soil performance | Good with proper base | Good; torque confirms bearing |

| Rocky soil | Manageable (jackhammer) | Difficult; may need relocation |

For how footing costs fit into total deck pricing, see the Kitchener deck cost guide or the Waterloo pricing guide.

Ontario Frost Depth by Region

Always confirm with your local building department — site-specific conditions sometimes push the requirement deeper.

When You Need an Engineer's Stamp

Not every footing needs a professional engineer, but several situations make it necessary in KWC:

For full permit requirements, check the deck permit drawings checklist.

What to Ask Your Builder About Footings

The Bottom Line

Both sonotubes and helical piles build solid Ontario deck guides when installed correctly. Sonotubes are the budget-friendly default for sites with good access and warm-weather timelines. Helical piles cost more per unit but save time, work in more seasons, and cause less disruption. The right choice depends on your site, your timeline, and your budget.

---
